Prosper, TX SWPPP & Stormwater Requirements

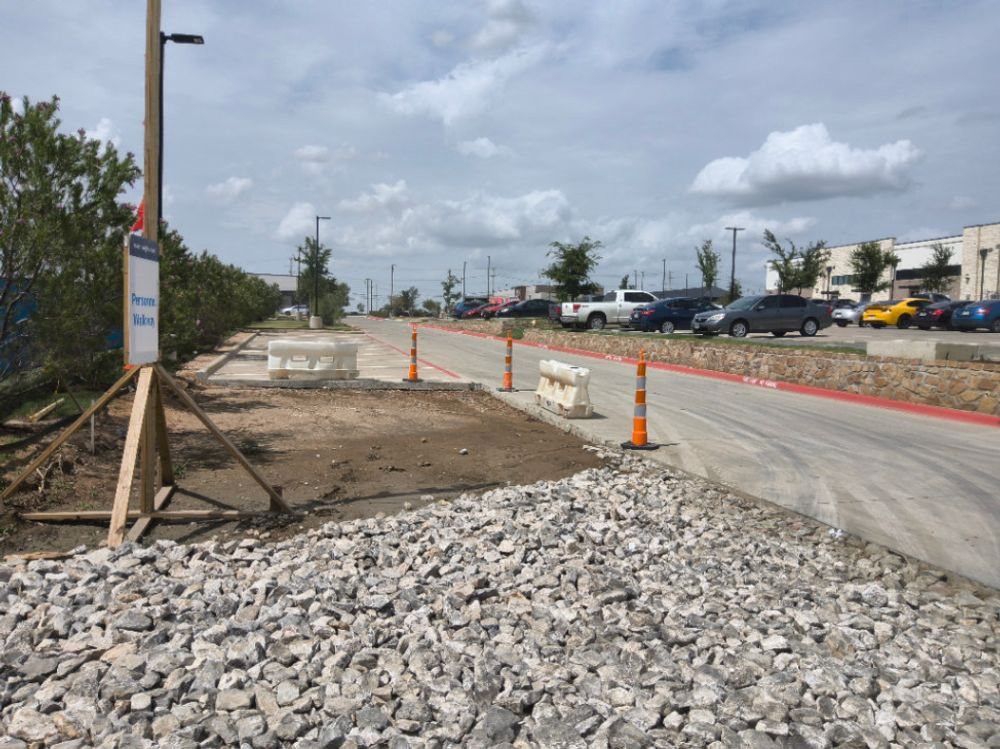

Stabilized rock construction entrance at a Prosper retail development

Updated July 2026

Prosper runs its construction stormwater program out of its own ordinance and its own field guidance, and both are specific about who does what. Prosper stormwater requirements are town rules layered on top of the state permit — and the town's inspection clock runs faster.

What does Prosper require for SWPPP compliance?

The centerpiece is the inspection rhythm. Prosper's stormwater ordinance requires qualified personnel to inspect disturbed areas that have not been finally stabilized, exposed material storage areas, structural control measures, and vehicle entry and exit points at least once every seven calendar days.

Inspections: the seven-day rhythm

The state default is slower. TXR150000's standard schedule requires construction site inspections at least once every 14 calendar days and within 24 hours of the end of a storm event of 0.5 inches or greater. Findings carry their own duty in town. Based on inspection results, Prosper's ordinance requires best management practices to be revised as appropriate, and as soon as is practicable. Weekly self-inspections mean the compliance record never sleeps — a standing inspection program beats a scramble every time. Terradyne provides routine SWPPP inspection reports with cloud-based client access. See SWPPP Inspections for how the program works.

Everyone signs: the certification statement

Prosper puts every company on the plan on the hook, in writing. Prosper requires all contractors and subcontractors identified in an SWPPP to sign a certification statement — beginning "I certify under penalty of law" — before conducting any professional service identified in the SWPPP. Collect those signatures at buyout, not at mobilization: a sub who has not signed is a sub who cannot legally start the work the plan names.

The town's field rules

Prosper's pollution-prevention guidance reads like an inspector's checklist, and treating it that way keeps a site clean. The Town of Prosper directs builders to use straw wattles, silt fences, or other control measures to prevent the flow of silt off the site — and requires that controls be effective and maintained. Prosper directs crews to keep excavated soil on the site where it is least likely to collect in the street, and to transfer soil to dump trucks on the site — not in the street. Weather is part of the plan too: Prosper's construction pollution-prevention guidance says never to schedule earth-moving activities when rain is forecast — and to implement effective control measures to prevent erosion if grading must be conducted during wet weather.

For the controls themselves, see Silt Fence Installation for the perimeter and Sediment Logs & Wattles for the contour and curb-line work the town's guidance names.

Check before you mobilize

Ordinances and town standards get revised; confirm the current documents with the town before you mobilize. For other North Texas cities, start at Local Compliance.

Frequently Asked Questions

How often are SWPPP inspections required in Prosper?

Weekly — the town's ordinance sets the self-inspection duty in calendar days and it covers the disturbed ground, stockpiles, controls, and every point where trucks enter or leave. The exact requirement is quoted above; build the inspection contract around the town's rhythm, not the state's.

What do contractors have to sign in Prosper?

Every contractor and subcontractor named in the stormwater plan signs a certification — under penalty of law — before doing any work the plan identifies. Get the signatures collected when the sub is bought out so nobody is standing idle at mobilization waiting on paperwork.

What does Prosper expect for silt control?

Controls that actually work and keep working: wattles, silt fence, or equivalent measures holding silt on site, maintained through the job. The town's guidance also keeps soil handling on site — loading trucks on the pad, never in the street.

Can we grade if rain is in the forecast?

The town's guidance says do not schedule earth-moving when rain is forecast — and if wet-weather grading is unavoidable, effective controls have to be in place before the weather arrives. Plan the dirt schedule with the forecast on the wall.
